Wednesday, March 22, 2023

J107 - Tawas update Q1

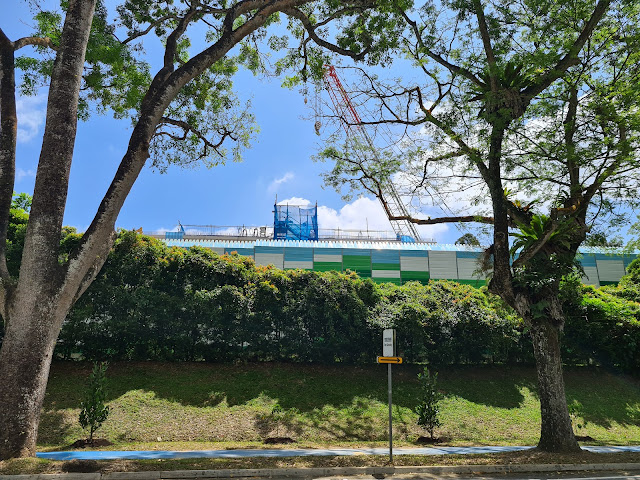

12 March 2023 - A view of the station's construction, just north of the Pan Island Expressway.

12 March 2023 - A close up view of the station's construction. The concourse level can be seen
shaping up.

Tawas station is being constructed under contract J107. Located in a greenfield site north of the Pan Island Expressway (PIE) near Cleantech Park, the station is progressing quickly. The concourse level can be seen being constructed, with the majority of the station's piers already up and ready for the subsequent stage of works. Similar to Gek Poh station across the PIE to the south, Tawas station will sit atop a future road that runs beneath.


12 March 2023

While one is able to catch a glimpse of the station's construction from south of the PIE, there do not appear to be many viaduct piers visible from this angle north of the station. Foliage towards the south also obstructs a good view for the time being.

12 March 2023 - Viaduct columns coming up on the site of the former Pioneer Primary School.

12 March 2023 - Most of the viaduct piers are at the rebar installation stage.

12 March 2023 - One of the piers is having formwork installed ahead of casting works.

Across the PIE however, viaduct columns can be seen sprouting up on the site of the former Pioneer Primary School. Work here has progressed quickly since the school was merged with another primary school and its former campus demolished. Now, several viaduct piers stand as the rebar skeleton has been woven together before formwork is installed ahead of casting.

12 March 2023 - A pier with SBGs installed.

12 March 2023 - A close up of the pier with 1 set of SBGs on either side
of each trackway.

To the north of the station however, several piers can be seen with launching of segmental box girders (SBGs) already being launched. The balanced cantilever technique is being used here, however without the use of lifting frames or hanger beams. Instead, a mobile crane had been used to lift the SBGs onto a platform from which they are joined to the main pier.

January 2023 - The first segment being lifted into place.
Source: LinkedIn

January 2023
Source: LinkedIn

January 2023 - First segment almost in place.
Source: LinkedIn

The first segments were lifted into place some time in January. Since then, there has been further progress with a total of 4 SBGs launched on either side of each trackway at one pier in particular. Another pier also features 1 SBG on either side of both trackways.

12 March 2023 - Seen from Nanyang Crescent, this pier has 4 SBGs placed into position on
either side of each trackway.

12 March 2023 - A view of the pier & SBG launching seen from Nanyang Avenue.

12 March 2023

12 March 2023 - A view of the pier and SBG launching using the balanced cantilevered method.

12 March 2023 - A close up view of the pier with SBGs launched. The preceding pier can
be seen in the foreground on the left whilst the following pier can be made out on the right
in the background, awaiting crosshead casting.

12 March 2023 - The next two piers visible. One awaits casting while the second has also
commenced SBG launching.

12 March 2023 - Barely visible, the pier & viaduct seen from Nanyang Crescent.

12 March 2023 - Higher up, one can catch a glimpse through the foliage of the progress of SBG
launching.

It is heartening to see the progress of construction near the Tawas station site. According to contractor Chip Eng Seng - Sembcorp Development Corporation, viaduct launching works are targeted to commence in mid-March further south near Gek Poh station. We look forward to continued progress here near Tawas & further south at Gek Poh in time to come. Do stay tuned for our on-going series on the stages in constructing an elevated MRT line and as we bring you further updates on the progress of construction across the various sites.

This post is also available on Instagram & Facebook.
