 |
An aerial view of the Boon Lay Jurong Region Line station in early & end Q1. |
A lot has been happening at Boon Lay station on the East-West Line (EWL) as it prepares to be upgraded into an interchange with the upcoming Jurong Region Line (JRL). In addition to the new station being built, the existing station is undergoing several changes to cope with the increased passenger loads and commuter traffic. These works are being carried out under contract J106 which oversees the construction of the new station as well as the addition & alteration works to the existing EWL station. Milestones hit by the contract this past quarter include the completion of the roof frame installation, commencement of the construction of a replacement staircase within the existing station and the beginning of reinstatement works along Jurong West Street 64. We'll explore all these in greater detail after the jump.
JS8 - Boon Lay

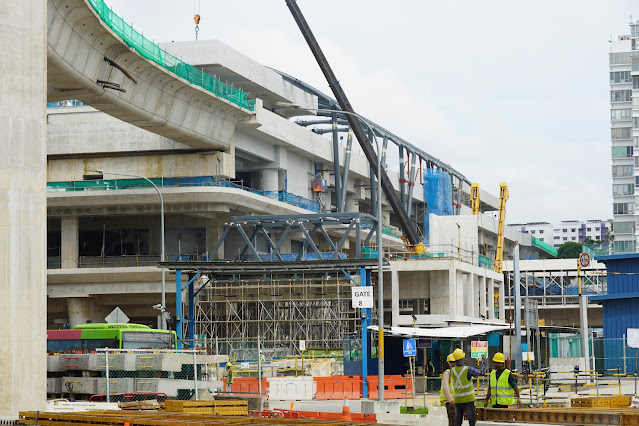

The massive new JRL station looms over the existing viaducts of the EWL as the station progresses ever higher with the installation of the roof frame. Below the station, works also saw the rerouting of pedestrian footpaths, allowing a shorter route between the junction of Jurong West Streets 64 & 63 with the Jurong Point Shopping Centre. It is anticipated that by Q3, Jurong West Street 64 may be able to return to its old alignment, running beneath the new station structure.
 |
13 March 2025 - An aerial view of the new JRL station, sitting above Jurong West Street 64 and the existing EWL viaducts, in end Q1. |
 |
25 January 2025 - An aerial view of the new JRL station in early Q1. |
JRL station structure
Through Q1, roof frame installation works continued with more and more segments of the roof frame being assembled over the station's concourse and platform levels. The design of the roof frame employs the use of V-columns, akin to those used at Hong Kah & Corporation stations, albeit much taller to span the height of 2 levels instead of 1. By the end of Q1, the frame's assembly had been completed and would likely proceed onto fit out works. One difference to note is that for other stations thus far, the lift shaft frames have made an appearance at the platform level before the roof frames were installed overhead. These have so far been absent from Boon Lay station.
At the lower levels - the concourse & mezzanine levels, works have been ongoing to create rooms through the installation of precast wall sections. This work continued on through Q1 as well.
 |
25 January 2025 - An aerial view in early Q1 of the roof frame being assembled over the platform level. |
 |
25 January 2025 - A view of the new JRL station building as seen from the pedestrian overhead bridge across Boon Lay Way in early Q1. |
 |
25 January 2025 - Casting of staircase underway within the station building to connect the concourse and platform levels. |
 |
25 January 2025 - A view of the station's profile from the western end. |
 |
13 March 2025 - An aerial view in end-Q1 showing the completion of the roof frame assembly. Additional fit out works were being carried out with the installation of crossbars for the jacked roof portion that allows ventilation and the installation of the gutter to prevent excessive water flow over the edge of the roof. |
 |
13 March 2025 - An aerial view from the north of the station building and approach viaducts. |
 |
13 March 2025 - Hoisting of precast wall segments underway. |
 |
13 March 2025 - Waterproofing membrane work was underway on the roof of the plant rooms at the station's northern end. |
 |
13 March 2025 - A view of the completed frame for the roof with works moving onto the fit out stage. |
JRL station Exit 5 podium
The new JRL station will see the addition of 4 new exits to the interchange complex. The first of these exits is located next to Jurong Point and will be numbered as Exit 5. Through the past quarter, the structure of the exit podium has grown from just being a base structure to reaching the mezzanine level.
 |
25 January 2025 - A view of the works for the Exit 5 podium at base level in early-Q1. |
 |
25 January 2025 - A close up view of works in progress at the base of the Exit 5 podium. |
 |
25 January 2025 |
 |
13 March 2025 - A view of the Exit 5 podium structure from the same location in end-Q1. |
.jpg) |
13 March 2025 - An aerial view of the Exit 5 podium structure in end-Q1. |
 |
13 March 2025 |
 |
16 March 2025 - A view of the Exit 5 podium structure from outside Jurong Point shopping mall. |
JRL station Exit 6 podium
Works for the Exit 6 podium began to accelerate over the past quarter, with casting for the podium's structure taking place to increase the structure's height. Located next to block 664B, the exit will see a linkbridge connecting the exit with the station across the canal leading to the Jurong River.
 |
25 January 2025 - A view of the base of the exit podium of Exit 6 in early-Q1. |
 |
25 January 2025 - The base was cast with rebar for the columns sticking up. |
 |
25 January 2025 - Another view of the podium's base structure. |
 |
13 March 2025 - A view of the progress of works for the exit podium structure. |
 |
13 March 2025 - A view of the exit podium in relation to the station building in end-Q1. |
 |
13 March 2025 - Concrete pumping works for structure casting underway in end-Q1. |
 |
13 March 2025 |
 |
13 March 2025 - A view of the progress of works at the exit podium next to the station. |
JRL station Exit 7 podium

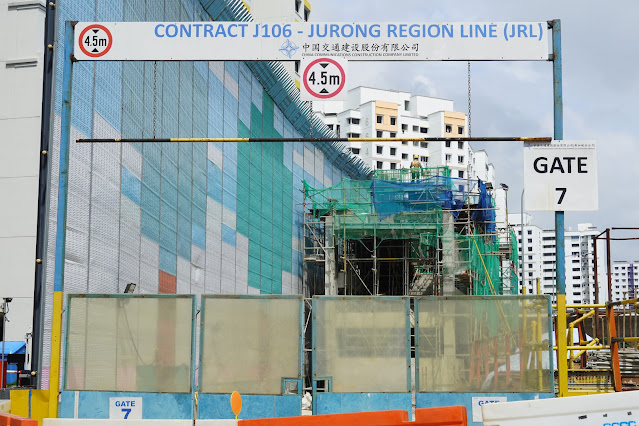

The podium structure for Exit 7 has been silently progressing through the end of 2024. In the past quarter, the structure has continued to take shape with the podium reaching mezzanine level height. By the end of the quarter, rebar for the side beams where the escalators will be installed was in place. Similar to Exit 6, this exit will also connect to the station via a linkbridge that spans across the same canal leading to the Jurong River.
 |
25 January 2025 - The podium structure for Exit 7 taking shape in early-Q1. |
 |
25 January 2025 - Casting and rebar work in progress to build the structure to the intended height. |
 |
25 January 2025 - The Exit 7 podium structure in relation to the station building. |
 |
25 January 2025 - A view of the podium structure from the north. The escalators will eventually be installed on this side. |
 |
13 March 2025 - An aerial view of the exit's podium structure. The lift shaft had attained full height. |
 |
13 March 2025 - A view of the exit's podium structure from the north in end-Q1. Rebar for the side beams one either side of the future pair of escalators has been installed. |
 |
13 March 2025 - A view of the exit's podium structure from the south in end-Q1. Casting works for the stairwell are likely completed, with roof components likely to make up the remaining structure. |
JRL station Exit 8 podium & linkbridge
One of the earliest structures to make an appearance has been the Exit 8 podium and its linkbridge. Works for these had commenced in 2024 and the structure was largely completed by the beginning of 2025.
 |
25 January 2025 |
 |
25 January 2025 |
 |
25 January 2025 |
 |
25 January 2025 |
 |
25 January 2025 |
 |
13 March 2025 |
 |
13 March 2025 |
Paid transfer connection
The paid transfer connection will see the existing EWL station platform extended further west, connecting to 2 banks of escalators and ending at 2 lifts that connect to the JRL platforms 2 floors up. Over the past quarter, steady progress has been made on the transfer linkway which has progressively inched eastwards from the JRL station structure towards the existing EWL station. En route, several plant rooms at ground level have been constructed.
 |
25 January 2025 - An aerial view of the transfer linkway, with the stairs connecting the transfer bridge to the concourse level of the JRL station. |
 |
29 January 2025 - A view of construction at the western end of the existing EWL station. Modification works will be needed to relocate existing plant rooms here away before the connection can be finally made. |
 |
13 March 2025 - A view of the transfer linkway from ground level. The newly constructed plant rooms can be seen. |
 |
13 March 2025 - A view of the transfer linkway ending at the 2 lift shafts. |
EWL station modification works (Exit C)
During the middle of the quarter, Exit C at the existing EWL station was closed to allow for modification works to take place. These works will see an extra staircase being built to replace the existing staircase, which will make way for another set of escalators to be installed in its place. Following the closure of the Exit C corridor, which connects Jurong Point & the Boon Lay bus interchange with the concourse fare unpaid section, assembly for the metal staircase began. By the end of the quarter, the structure of the new staircase could be seen in place.
 |
25 January 2025 - A view of Exit C in early Q1. |
 |
25 January 2025 - A view of the corridor towards Exit C, from the concourse fare unpaid zone. |
 |
25 January 2025 - The existing condition of the staircase and a section covered by grey netting where the replacement staircase would be constructed. |
 |
25 January 2025 - The new staircase would punch through where the hoarding & grey netting is located. |
 |
29 January 2025 - A view from within the station's fare paid zone of the hoarded up area where the new staircase would connect. |
 |
29 January 2025 - A notice of the exit's upcoming closure. |
 |

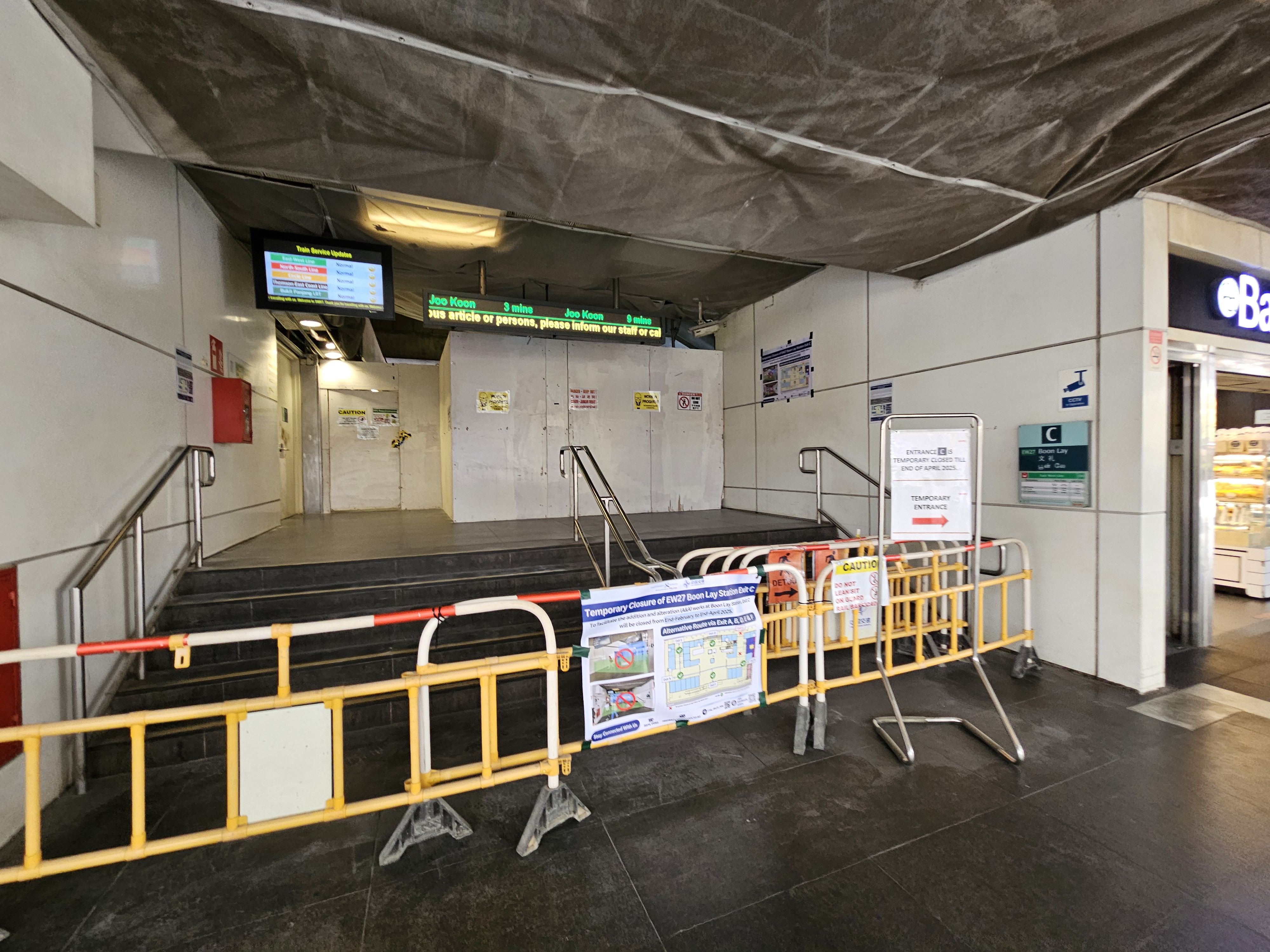

13 March 2025 - The close off corridor to the exit in end Q1. |
 |
13 March 2025 - A view of the exit front as seen from the Jurong Point side. |
 |
13 March 2025 - The steel beams for the new staircase can be seen in place as of end Q1. |
 |
13 March 2025 - A view from within the station's fare paid zone, with beams for the new staircase clearly visible behind the hoarding. |
 |
13 March 2025 - A construction worker making adjustments to the steel beams that support the new staircase. |
 |
13 March 2025 - An aerial view through the atrium. Metal beams for the new staircase can be seen through the grey netting. |
EWL station Exit D modifications
Exit D of the station had also undergone several changes, with works to push the access stairs out further towards Jurong Point mostly coming to an end. This will create a larger fare paid zone as the faregates will also be realigned further towards Jurong Point.
 |
25 January 2025 - A view of Exit D in early Q1. The centre section of the stairs was undergoing works to push the alignment outwards. |
 |
25 January 2025 |
 |
25 January 2025 - The centre section of the stairs hoarded up for works. |
 |
25 January 2025 |
 |
29 January 2025 - A view of the location of the future faregates, which will serve to create a larger fare paid area. |
 |
29 January 2025 - Another view of the location of the existing fare gates and the future fare line. |
 |
13 March 2025 - Hoarding for the centre section of stairs since removed by end Q1. |
 |
13 March 2025 - The fare gates remain in their existing position as of end Q1. |
 |
13 March 2025 - A view of the existing fare paid area from the fare unpaid area of the concourse. |
JRL viaduct works
With segment launching works completed, work on the JRL viaduct focused on completing the structure for handover to the trackworks contractor. These works included the assembly of the parapet walls, waterproofing layer and cable racks & troughs along the viaduct. The majority of these works were at the tail end by the end of the quarter, with all parapet walls assembled by then. Road infrastructure reinstatement works were slowly beginning by then, with these works commencing at the northern end of the contract, near the interface with contractor J105 at the junction of Jurong West Streets 64 and 65.
 |
25 January 2025 - A view of the viaduct south of the station. Two spans of viaduct had yet to have any parapet walls installed at this point. |
 |
25 January 2025 - An aerial view of the viaducts south of the station, with parapet wall installation in progress in early Q1. |
 |
25 January 2025 - An aerial view of the viaducts north of the station. Lifting frames were still visible on the Jurong Pier-bound track while there was still an absence of parapet walls. |
 |
25 January 2025 - A view of the viaducts looking northwards at street level, opposite the Frontier Community Club. |
 |
25 January 2025 - The machine on the viaduct was a small crane system that allowed for the lifting of parapet wall segments into place. |
 |
25 January 2025 - Ongoing parapet wall installation works in progress next to the Frontier Community Club. This deck section stretches over two viaduct spans and will be where the crossovers will be located, allowing trains to switch directions during phase 1 operations. |
 |
25 January 2025 - A section with parapet wall installation completed. The crossover deck ends where the centre parapet walls commence. |
 |
13 March 2025 - An aerial view of the viaducts south of the station building in end Q1. |
 |
13 March 2025 - Parapet wall installation had since been completed, with cable racks being installed. Cable troughs were also being lined along the viaduct span. |
 |
13 March 2025 - An aerial view of the viaduct spans north of the station building, parapet walls since installed. |
 |
13 March 2025 - Work ongoing for the installation of various supporting infrastructure for cabling. |
 |
13 March 2025 - The two small cranes used for parapet wall segment installation remain on deck. This section will be where the crossovers will be located. |
 |
13 March 2025 - A view of the largely completed viaduct sections towards the north. |
 |
13 March 2025 - Work ongoing at the interface of a movement & expansion joint. |
 |
13 March 2025 - A view of the completed viaducts at the interface with contract J105, near the junction of Jurong West Streets 64 & 65. |
 |
13 March 2025 - A view of the nearly completed structural works for the viaduct looking southwards along Jurong West Street 64. |
 |
13 March 2025 - Road infrastructure reinstatement works commencing in the road median along Jurong West Street 64. These begin with drainage construction in the road median. |
 |
13 March 2025 - Road infrastructure reinstatement works underway. |
Contract J106 has seen much progress through Q1 in the lead up to viaduct handover to the trackworks contractor. As the station shapes up, the existing EWL station also begins to change with modification works commencing in earnest. A long road remains ahead, with the new staircase to be built, a new escalator to be fit in and a new lift to be constructed. We'll do our best to bring you up to date with all the goings-on over time. Do stay tuned for more updates coming your way!
