|
Overview of JRL stations
JW1 - JW2 & JE1 - JE7 as of October 2024.
Top (L - R): JW1 - Gek Poh, JW2 - Tawas, JE1 - Tengah Plantation
Middle (L - R): JE2 - Tengah Park, JE3 - Bukit Batok West, JE4 - Toh Guan
Bottom (L - R): JE5 - Jurong East, JE6 - Jurong Town Hall, JE7 - Pandan
Reservoir |
|
Overview of JRL stations
JW3 - JW5 & JS9 - JS12 as of October 2024.
Top (L - R): JS9 – Enterprise, JS10 – Tukang, JS11 – Jurong HillJW3 - Nanyang
Gateway
Middle (L - R): JS12 – Jurong Pier, JW3 – Nanyang Crescent, JW4 – Nanyang
Gateway
Bottom (L - R): JW5 – Peng Kang Hill, Contract J101 Tengah depot, Contract
J120 Jurong East ITH |
Into the fourth quarter of 2024 we go. Work at the various sites of the Jurong Region Line (JRL) continues to chug along with different sites focusing on different stages of work. We bring a brief update of the progress made since the last update in September 2024.
|
A short summary of the various station construction statuses as of October 2024. |
Phase 1
"Time goes by... so slowly..." said no one, except Madonna in her song Hung Up. We experience it differently though, with time going by really quickly. The contractors for phase 1 of the line must surely be feeling the pressure as deadlines loom ahead as the pace of work picks up. With several of the stations receiving their roof structures in, others are getting the plant rooms at platform level built. Viaduct construction is well underway with the last few remaining sections approaching completion under contracts J106 and J107, while other wider gaps still remain for contracts J102, J103 and J105.
Tengah depot (Contract J101)
In a nutshell: Work continues to progress at the site, with the operations control centre (OCC) building taking shape as more floors are added to the structure. The services bridge that connects cabling and pipes connecting utility lines from the load centre to the workshops and stabling sheds has made progress with most of the spans since installed. Several more tracks can be seen laid out within the project site, including the test track along the western end of the depot.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS1 -
Choa Chu Kang (Contract J102)
In a nutshell: Since the opening of the new concourse-to-platform link at the northern end of the station, the former upriding escalator at this end has been cordoned off, together with the former staircase. Hoarding was being put up ahead of the structure's disassembly and subsequent demolition. The area where the former interim shops stood has been reconfigured with a winding path beneath the existing and new stations allowing commuters to access Choa Chu Kang Loop. Along the way, some glimpses of the newer sections of the station can be seen.
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS2 -
Choa Chu Kang West (Contract J102)
In a nutshell: Viaduct construction works were in full swing along Choa Chu Kang Avenue 3, along which the station is sited. The first span connecting to the portal piers at the junction with Choa Chu Kang Way has about been completed and the machinery is likely to be disassembled and relocated to the next pier for the works to commence there. Further west, launch gantry Mulan was in the midst of completing a span across the junction with Choa Chu Kang Avenues 4 and 5. 7 spans remained to be constructed by the gantry before its decommissioning, at the time of visit.
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
JS3 -
Tengah (Contract J102)
In a nutshell: Work was progressing for the plant rooms on either end of the upper platform level. Launch gantry Gaia was operating towards the north of the station assembling viaduct decks for both the upper and lower levels.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS4 -
Hong Kah (Contract J103)

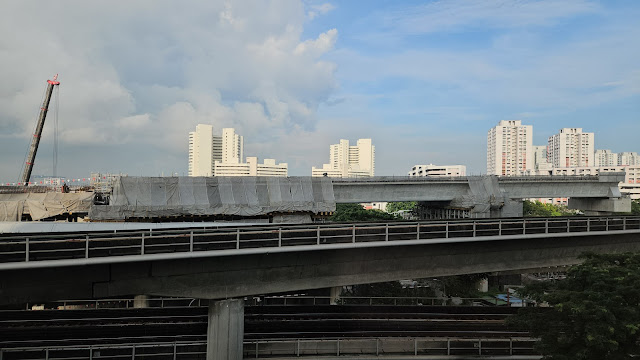

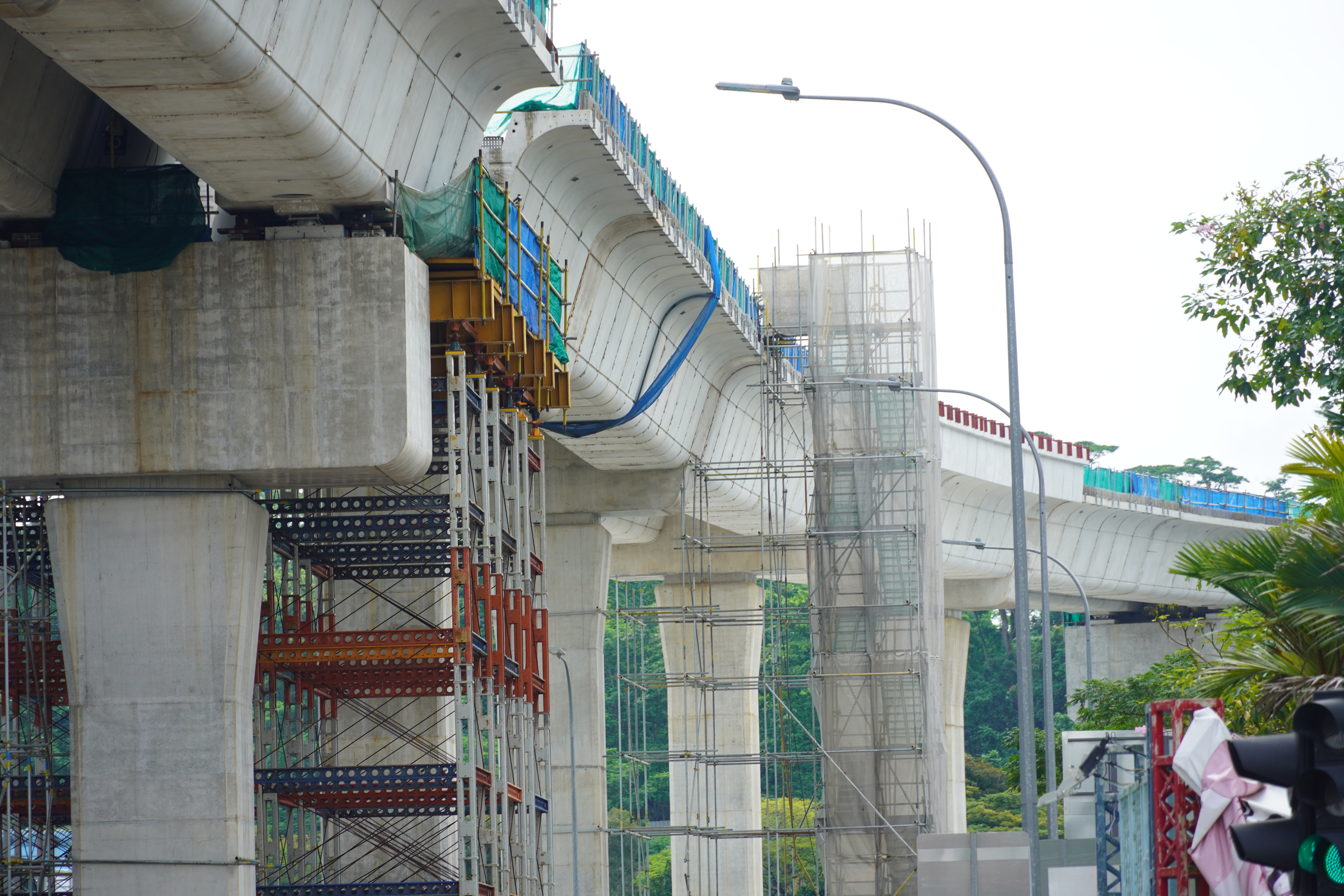

In a nutshell: By the month's end, 6 pairs of V-columns to support the station's roof had been installed out of a total 7 pairs. Work was also in progress for the construction of the link bridge that would connect to an exit located on the opposite side of Tengah Garden Avenue.
|
13 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
13 October 2024 |
Mainline viaducts between JS4 & JS5 and Reception tracks to depot (Contract J103)
In a nutshell: By the end of the month, viaduct segment launching works had commenced on span across the Pan Island Expressway (PIE) for the main line viaduct. The western reception track spans were making good progress towards structural completion, with the casting of the crosshead for a movement & expansion joint pier nearing completion. However, several piers for the eastern reception tracks were still missing or were still stuck at the foundation level, with no columns cast yet. There remains much work to be done before structural completion can be attained.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
20 October 2024 |
JS5 -
Corporation (Contract J103)
In a nutshell: Road realignment has been taking place in the vicinity of the station to allow construction to progress onto the next stage of work - construction of the station's exits. This station will now feature 3 exits, with an exit near the former Jurong Junior College campus since deferred. While the lift shafts have been installed in the station, escalator installation had yet to commence. The viaducts to the west of the station had made significant progress with only the portions nearer to the station to be completed.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS6 -
Jurong West (Contract J105)
In a nutshell: The station utilises a Y-column design for its roof structure, unlike the stations under contract J103. In total, there are 6 pairs of Y-columns that support the roof structure, with all 6 pairs installed. Roofing works were underway along with piling for the station's 3 exits. Viaduct construction still continues as the station has yet to be connected with any viaduct spans. Several spans remain to be completed near the station building and near the junction with Jalan Bahar & Jalan Boon Lay. Parapet wall installation has made decent headway along the completed sections of viaducts towards Bahar Junction station.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS7 -
Bahar Junction (Contract J105)
In a nutshell: The main station building saw the commencement of roof structure installation works while the satellite building was still focused on works at the concourse level. Casting works for the connecting linkbridge was underway with the structure beginning to take shape at concourse level. Viaduct span construction was continuing at the busy junction, with the Choa Chu Kang-bound trackway nearly completed for its portion of the Y-junction. Work still continued along the Jurong Pier-bound trackway as several gaps remained where segments were yet to be launched.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS8 -
Boon Lay (Contract J106)
In a nutshell: Station construction works saw the casting of the concourse slab over the existing East-West Line (EWL) viaduct take place, bridging the two separate halves of the station together. The central portion of the station still had some casting work remaining at the concourse level slab on the northern side while works progressed to the platform level on either end of the station. The first pair of V-columns to support the roof structure began installation at the southern end of the station as well. Eventually there would be approximately 7 pairs of these V-columns. Approximately 3 to 5 pockets of viaduct segments remained to be launched for all viaduct span construction under the contract to be completed.
|
12 October 2024 |
|
12 October 2024 |
|
12 October 2024 |
|
12 October 2024 |
|
12 October 2024 |
|
13 October 2024 |
JW1 -
Gek Poh (Contract J107)
In a nutshell: Work at the station building saw the casting of permanent structures at the concourse slab level while installation of the arms began at platform level. These arms would eventually assist in supporting the platform level above the concourse without the need for further columns. Several gaps remained in the viaduct's structure south of the station but were likely to be completed towards the end of the year.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024
|
JW2 -
Tawas (Contract J107)
In a nutshell: In this section of the contract, the southern span of the PIE crossing had been completed while casting for the pier supporting the span on the northern side of expressway was completed. Works would soon shift towards the northern side where the process would be repeated again to bridge the gap between the piers. Station building construction saw the plant rooms at platform level being cast while segments of the roof structure were also seen on site, awaiting installation. Along the viaduct south of the station towards Gek Poh, parapet wall installation had begun.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
Phase 2
This picture might sound familiar to you - that one over-achiever in class that likes to show off, peacocking their stuff. You know, that kid, the teacher's pet that always got the highest marks in class. This phase has one such station in Tengah Park which has progressed so quickly that it sticks out like a sore thumb. The rest of the sections along this phase are a little more chill, a little more laid back in the pace of works, keeping to a somewhat reasonable rhythm with the 2028 deadline in mind.
JE1 - Tengah Plantation (Contract J108)
In a nutshell: The station's trackbeds are ready but work almost appears to be on hold - likely waiting for the launch gantry Magnificent Mammoth to complete the connecting viaduct spans on the station's eastern end. Once these are completed, the gantry will likely march through the station to complete the remaining spans on the western end of the station to the contract boundary with contract J102. The works along this section are expected to last till Q1 2025 as seen in a recent update on the contract's Telegram channel. Supports can be seen at the station's eastern end, likely to aid in supporting the weight of the launch gantry as it rests on the station building's structure.
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
JE2 - Tengah Park (Contract J108)
In a
nutshell: Now onto that over-achiever, which has had part of its roof structure installed. The design of the roof structure for the phase 2 stations adopts yet another design that differs from those seen along phase 1 thus far, with an intricate tangle of diamonds and interconnecting diagonal struts. In the early part of the month, 4 pairs of diamonds that connect the roof structure to the concourse level were installed from the station's southern end. The roof structure was connected to two of these diamonds then. By the end of the month, the roof structure had connected to the tops of 3 pairs of the diamonds. Elsewhere, along the viaduct, parapet wall installation was trucking along with significant stretches of the walls installed along viaducts on either side of the station.
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
6 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
JE3 - Bukit Batok West (Contract J108)
In a
nutshell: Here, 8 pairs of the station's columns were completed up to the concourse level, with the remaining 2 pairs still existed at the base level. At the station's western end, works had progressed sufficiently to the casting of the underplatform & trackbed levels. Viaduct assembly was also advancing, with the crossing of Bukit Batok Road taking shape visibly. The launch gantry Rock Steady, previously used to construct the viaduct south of Tengah Park station was recently shifted nearer to the contract boundary with contract J109 in anticipation of launching atop piers there.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
JE4 - Toh Guan (Contract J109)
In a
nutshell: Casting for 7 of the station's concourse level crossheads was completed, with an 8th about to begin towards the end of the month. As several of the crossheads had since been cast, installation of the connecting precast beams commenced. To the station's south, viaduct pier columns began to spring up along Jurong East Central to allow the line to climb over the existing EWL tracks en route to Jurong East. To the station's north, a significant section of viaduct had been completed on the northern side of the PIE, employing the use of several types of lifting frames for the works.
|
20 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
Tracks through Jurong East Integrated Transport Hub
(Contract J120)
In a
nutshell: The viaducts under the contract were being assembled fast & furiously, with at least 6 pairs of viaduct spans under construction. Over time, the split level nature of the viaducts will become more apparent as the works progress further eastwards, towards the integrated transport hub development.
|
20 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
10 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
20 October 2024 |
JE5 - Jurong East (Contract J110)
In a nutshell: The majority of the station building's construction has progressed to the lower platform level, with some columns extending towards the upper platform level. Work was in progress for the casting of the lower platform's trackbed as work on the station plaza also began to make progress. At the existing platforms E & F, hoarding had gone up for modification works to relocate a distribution board room to allow for additional escalators to be installed.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
10 October 2024 |
JE6 - Jurong Town Hall (Contract J109)
In a
nutshell: Work at the northern side of the station building had reached the platform level while the majority of the structure towards the south was still focused on the concourse level works. The first launch gantry for the contract had also completed 2 viaduct spans.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JE7 - Pandan Reservoir (Contract J107)
In a
nutshell: Works for the station building were progressing with the mezzanine level slab mostly completed. Towards the centre of the structure, columns that would support the concourse level had began to emerge. Further south, more viaduct pier columns began appearing along West Coast Road. Here, some of the viaduct piers had been completed to crown level while the pier columns towards the end of the contract began casting works for the pier crossheads.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
Phase 3 (South)
Works under this section of the line had made some progress with station structures beginning to take shape. Viaduct segment launching had also commenced with construction adopting various methods to complete the spans.
JS9 - Enterprise (Contract
J111)
In a nutshell: With most of the station columns cast at the street level, beam construction began at the station's centre portion. On either side of the station and along Jurong West Street 64, viaduct segment launching was underway. To cross over the Jurong River, it appeared that the viaduct spans were being constructed by form travellers.
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
|
13 October 2024 |
JS10
- Tukang (Contract J111)
In a nutshell: The majority of the station's pier columns were set up with scaffolding to begin construction of the concourse level crossheads. The single viaduct pier to the site's southern end was also having the temporary support structures installed for crosshead casting to allow neighbouring contract J112 to connect its section of viaduct spans.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
JS11
- Jurong Hill (Contract J112)
In a nutshell: Thus far, three station pier columns were cast at the station site. No other piers were yet visible at the section to the south of the Ayer Rajah Expressway (AYE). On the other side of the expressway, two viaduct piers were in the midst of having the pier crossheads cast ahead of the commencement of viaduct span construction works.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
JS12
- Jurong Pier (Contract J112)
In a nutshell: Structural works for the station continued to progress, with various sections of the station becoming visible. Three columns in the station's centre, that would eventually support one of the station's tracks, remain as they were seen previously with no further noticeable changes. Some new additions to the station structure would be the low wall coming up along Jurong Pier Road. Apart from the station structure, no other works were immediately visible.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
Phase 3 (North)
The final phase of the line has been taking shape at an accelerated pace, with the works becoming more obvious. Station structures were progressively expanding and sections of viaducts were lengthening within the university grounds.
JW3 - Nanyang Gateway (Contract J113)
In a nutshell: Most of the beams for the station's concourse level were completed, with the section towards the station's centre having a slab cast. Several columns were also cast at concourse level. On either side of the station, viaduct spans had been completed.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
JW4 - Nanyang Crescent (Contract J113)
In a nutshell: The station's unique structure had began to take shape with the portions of at-grade platform becoming apparent. The future linkbridge, replacing the former connecting bridge between the National Institute of Education (NIE) and the north spine building of the university, could now be seen where the rebar was installed within the station ahead of casting works. Sections of the dividing walls separating the trackbed from the underplatform space could also be clearly seen.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
JW5 - Peng Kang Hill (Contract J115A)
In a nutshell: The final station on the section showed the beginning of the station column footings. Several viaduct piers to the station's south could be seen with the columns and crowns visible. To the station's north, the future embankment where the crossover would be located had also grown slightly as the columns were cast further upwards. A series of viaduct piers nearby began casting of the pier crossheads.
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
|
20 October 2024 |
